11

In this post, Erwin Kalvelagen describes a method to compute all paths between two nodes in a given network, such that:

  • no arc is used more than once
  • a given path does not contain more than $M$ arcs

Note that nodes can be revisited, and this is part of the difficulty. His approach is well described and involves using the line graph, MTZ constraints, and a solution pool approach.

Are there other ways to tackle this problem (brute force excluded) ?


This problem was initially posted on stackoverflow, but the question seems to have been removed. I believe it is of interest to the OR community, as the problem is more complicated than it looks.

@ErwinKalvelagen, feel free to post bits of your answer here, will be happy to upvote it given that it originated this post.

Kuifje
  • 13,324
  • 1
  • 23
  • 56
  • 1
    Does brute force count? – prubin Mar 01 '22 at 21:47
  • 1
    @prubin I will leave the community be the judge of that :) of course if we can avoid brute force with shortcuts and tricks, life is better. – Kuifje Mar 01 '22 at 22:14
  • Maybe ... but sometimes brute force is faster than an elegant mathematical model. – prubin Mar 01 '22 at 22:15
  • I like your pragmatism. I will nuance your comment with the fact that I I don't see much brute force on your blog and on Erwin's :) – Kuifje Mar 01 '22 at 22:18
  • As an academic, I learned long ago that "practical" and "publishable" were, shall we say, not synonymous. :-) With the blog, it's more a case that brute force is generally not interesting enough to be worth reading about. I would not be surprised if Erwin felt the same way. – prubin Mar 02 '22 at 00:29
  • Aren't all resolutions of the traveling salesman problem ultimately dependent on brute force, as the number of nodes increases, if circular paths are permitted (as OP seems to indicate they are)? – tbrookside Mar 02 '22 at 12:48
  • @tbrookside No not really. The whole point of optimization techniques is to avoid brute force, in order to push back the inevitable combinatory explosion. On the other hand, all exact resolutions of the TSP have an exponential running time nevertheless. – Kuifje Mar 02 '22 at 13:00
  • Not an answer, but have you looked into ranking paths between the nodes. There is quite some literature on finding the $K$ shortest paths in a network. – Sune Mar 03 '22 at 21:39
  • That's actually a great idea. I added another answer with this idea. – Kuifje Mar 04 '22 at 09:29
  • @Kuifje, thanks for sharing the insights and files. Would you say please, what is the benefit for enumerating all of the paths in the graph, specifically in the real situation? And would you try to use the critical path method, with some tweaks, to capture what you want? – A.Omidi Mar 05 '22 at 13:20
  • @A.Omidi I do not know what the initial motivation of this question was, as it has been removed (on stackoverflow). I guess this could be interesting for MIP formulations where variables are paths. Ideally, these are generated dynamically with a column generation approach. But having at least a subset beforehand can be handy. What is the critical path method you are mentioning ? – Kuifje Mar 05 '22 at 13:35
  • @Kuifje, many thanks. CPM is an algorithm to find the longest path on the network, being precise a project scheduling network, to calculate the end time of the project based on some of the criteria. It counts the network paths somehow to do that. It is a very useful heuristic on huge networks. I think by some tweaks we can find all the paths by using that. – A.Omidi Mar 05 '22 at 13:53
  • @Kuifje, I have tried to use the CPM to enumerate the Paths on the simple example and compare the result with your provided template. For this simple example, the results are the same. Certainly, I should work on the limited number of paths constraint too. As I am not a professional python user to illustrate the output visualizing for CPM I apologize. I would like to know your insight about that. Also, I have used a standard template to calculate the CPM. :) – A.Omidi Mar 06 '22 at 14:40
  • @A.Omidi interesting ! I think it would be of interest if you posted an answer describing the method with more details. – Kuifje Mar 06 '22 at 15:40
  • @Kuifje, Many thanks. I will do that ASAP. – A.Omidi Mar 06 '22 at 15:45

5 Answers5

8

I would solve this using the following approach:

  1. Compute the shortest path with a MIP, with an additional constraint to limit the number of arcs in the path.
  2. If a path is found, store it, add a no good cut to exclude this path in the next iterations, and go to step 1. If no path is found, you are done.

The tricky part is to use the right no good cut for a given path $P$. It needs to exclude the path that has been found, except if it includes other edges of the network without forming a subtour (Erwin Kalvelagen used MTZ constraints to forbid subtours).

For example, if $P=1-8-10$, path $Q=1-8-3-8-10$ is a candidate (if $M=4$). On the other hand, a solution with edges $(1,8),(8,10),(4,4)$ (that is, $P$ with an isolated self-loop) must be forbidden. In other words, the no good cuts must ensure some sort of contiguity if edges from $P$ are used again.

This can be done as follows: $$ \sum_{(i,j)\in P}(1-x_{ij}) + \sum_{(i,j)\not \in P, i\in P \mbox{ or } j \in P}x_{ij} \ge 1 $$ This means that

  1. Either one of the edges of $P$ must take value $0$ (and so the path will be different from $P$) or
  2. Either one of the edges of the network not in $P$, but linked to $P$ must be used (in which case $P$ will have extra edges, without subtours).

My simulations with this approach match Erwin's results. Downside: you have to solve a series of MIPs, possibly many. Upside: no graph transformation (line graph), and no MTZ constraints.


EDIT

This strategy has the following flaw for graphs that have multiple subtours originating at a same node. For example consider paths $P=1-u-a-u-b-u-10$ and $Q=1-u-b-u-a-u-10$: they have the exact same edge set, but the order of the nodes differ. Once path $P$ is found, path $Q$ will become infeasible with respect to the no good cut associated with $P$. In other words the no good cuts are too strong.

There are at least two ways to fix this:

  1. Once a path is generated, check if this situation occurs and deduce all possible paths. This is doable but a bit tedious.
  2. Use the line graph. This is handy because with the line graph, no loops are possible. So the MIP can be solved on the line graph, with the following no good cuts for a given path $P$: \begin{align*} \sum_{((u,v),(x,y))\in P}(1-x_{u,v,x,y}) &\ge 1 \tag{1} \\ \sum_{((u,v),(x,y))\not \in P}x_{u,v,x,y} &\ge 2 \tag{2} \end{align*}

Constraints $(1)$ impose that at least one edge from $P$ must be removed and constraints $(2)$ impose that at least $2$ new edges must be selected.

With these new cuts, I get the following results, which match with the other approaches suggested in the other answers:

M 2 3 4 5 6 7 8 9 10
paths 1 4 9 21 32 53 98 165 268
Kuifje
  • 13,324
  • 1
  • 23
  • 56
  • 1
    You can strengthen the no-good cut from $\ge 1$ to $\ge 2$ because two such paths cannot differ by a single edge. You can also strengthen even further by disaggregating into two $\ge 1$ no-good cuts. – RobPratt Mar 01 '22 at 20:34
  • I'm curious what your overall solution time is to find all 9 paths with M=4 using this approach. I cobbled together some non-optimized Java code for the brute force method, and the run time is about 1 ms. on my PC (single threaded). The brute force code could be parallelized, but for this size problem that's not advisable. – prubin Mar 02 '22 at 20:11
  • 1
    When I run the (non-optimized) Python code within the Jupyter Notebook, with CBC, it takes 70 ms. So you are making a valid point. That said, for comparisons to be fair, experiments should be run in the same environment, with the same coding language etc. And above all, perhaps it is more interesting to see how the computation times evolve with the size of the graph (and with parameter $M$), rather than on a specific graph. I have noticed that the running time is very sensitive to the data set (more specifically the sparsity of the graph). – Kuifje Mar 03 '22 at 09:25
  • For a graph with $10-15$ nodes, sometimes it takes $1$ ms, sometimes it takes $10$ sec. I would have to check if using CPLEX makes a difference, and if using the strenghtened cuts proposed by RobPratt help accelerate. – Kuifje Mar 03 '22 at 09:26
  • I agree about testing on larger networks (and on the same platform). – prubin Mar 03 '22 at 17:20
  • With CPLEX, at least, you do not need to solve a sequence of MIPs. I coded a different MIP model, with an empty objective function (minimize 0) and used the "populate" function to generate all solutions to Erwin's test graph with $M=3$ and $M=4.$ – prubin Mar 03 '22 at 17:22
  • Interesting ! Would you like to share the MIP (if it is different from Erwin's) ? – Kuifje Mar 03 '22 at 17:26
  • I just added it as an answer. – prubin Mar 03 '22 at 19:27
  • @RobPratt Are you sure ? Consider path $P=1-8-3-8-10$. If $M=5$, another path is $Q=1-8-3-3-8-10$ (that is, $P$ with a self loop at node $3$). Both paths differ only by a single edge (the loop $(3,3)$) . – Kuifje Mar 04 '22 at 11:19
  • @Kuifje You are right that if the graph contains self loops, paths can differ by a single edge. – RobPratt Mar 04 '22 at 14:00
5

Yet another possibility suggested by @Sune, using $k$-shortest path algorithms :

The python module NetworkX provides an implementation of Yens's algorithm. Since the algorithm computes loopless paths, using the line graph like Erwin is necessary. Once the transformation is done, it is a one liner:

# create line graph
H = nx.line_graph(G)
new_edges = []
# add source and sink nodes
for (u,v) in H.nodes():
    if u==1:
        new_edges.append(("source",(u,v)))
    if v==10:
        new_edges.append(((u,v),"sink"))
H.add_edges_from(new_edges)

9 shortest paths

list(islice(nx.shortest_simple_paths(H, source="source", target="sink"), 9))

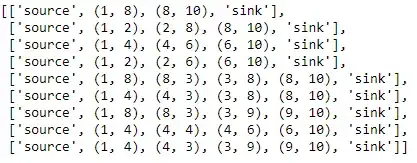

Erwin's graph is solved in less than $0.1$ ms, and the output is, as expected:

enter image description here

Kuifje
  • 13,324
  • 1
  • 23
  • 56
4

I tried an alternative (possibly over-engineered) MIP formulation, using Miller-Tucker-Zemlin variables. $A$ is the set of arcs in the graph, $s$ is the source node for all paths, and $t$ is the sink node for all paths. $M$ is the maximum path length. The variables are as follows.

  • $u_{a}\in\left\{ 0,1\right\} $ is 1 if and only if arc $a$ is used on the path.
  • $f_{a}\in\left\{ 0,1\right\} $ is 1 if and only if arc $a$ is the first arc on the path.
  • $\ell_{a}\in\left\{ 0,1\right\} $ is 1 if and only if arc $a$ is the last arc on the path.
  • $y_{ab}\in\left\{ 0,1\right\} $ is 1 if and only if arc $b$ immediately follows arc $a$ on the path.
  • $z_{a}\in\left[0,M\right]$ will be the number of arcs preceding arc $a$ on the path (0 if $a$ is not on the path).

We can fix the values of many of the variables up front.

  • $f_{a}=0$ if node $s$ is not the tail of arc $a.$
  • $\ell_{a}=0$ if node $t$ is not the head of arc $a.$
  • $y_{ab}=0$ if the head of arc $a$ is not the tail of arc $b.$

The constraints are as follows.

  • There must be one first arc and one last arc. $$\sum_{a\in A}f_{a}=1.$$ $$\sum_{a\in A}\ell_{a}=1.$$
  • At most $M$ arcs can be used. $$\sum_{a\in A}u_{a}\le M.$$
  • An arc is used if and only if it is either the first arc or follows another arc on the path. $$f_{a}+\sum_{b\in A}y_{ba}=u_{a}\quad\forall a\in A.$$
  • The last arc must be a used arc. $$\ell_{a}\le u_{a}\quad\forall a\in A.$$
  • The sequence value of an unused arc is 0. $$z_{a}\le Mu_{a}\quad\forall a\in A.$$
  • No arc can follow the last arc. $$\ell_{a}+\sum_{b\in A}y_{ab}\le1\quad\forall a\in A.$$
  • If an arc is used, either it is the last arc or another arc follows it. $$\ell_{a}+\sum_{b\in A}y_{ab}=u_{a}\quad\forall a\in A.$$
  • If an arc $b$ follows arc $a$, the sequence number of arc $b$ must be one higher than the sequence number of arc $a$ (MTZ). $$z_{a}-z_{b}+\left(M+1\right)y_{ab}\le M\quad\forall a,b\in A,a\neq b.$$

I omitted an objective function, which is equivalent to making the objective function minimizing a constant (0).

Rather than solving repeatedly with no-good constraints added after each new solution, I used the "populate" function in CPLEX with suitable parameters to get all feasible solutions in one gulp. That worked for $M=3$ and $M=4$, but on Erwin's graph with $M=10$ brute force found 268 paths and the populate function (with the highest intensity setting and a large pool capacity setting) found only 33.

prubin
  • 39,078
  • 3
  • 37
  • 104
  • Your $\ell_a \le u_a$ and $\ell_a + \sum_{b\in A} y_{ab} \le 1$ constraints are dominated by your $\ell_a + \sum_{b\in A} y_{ab} = u_a$ constraints. – RobPratt Mar 03 '22 at 20:16
  • Good point. I like to create any constraint that can't outrun me, and then let the presolver winnow the unhelpful ones. – prubin Mar 03 '22 at 20:55
  • I have noticed that the following situation can occur: you can have a path $P=s-a-b-a-c-a-t$ and another one $Q=s-a-c-a-b-a-t$ which have the exact same edges, but differ in the order of the nodes. The no good cut strategy therefore fails to find $Q$ once $P$ has been found, as the no good cut is too strong for $Q$ to be feasible. I am not sure if this is the reason why the populate function only finds $33$ paths with $M=10$. – Kuifje Mar 04 '22 at 18:33
  • It's possible, but I would be somewhat surprised. I don't think populate adds cuts to get rid of solutions. The nature of the branching process will prevent the same solution from recurring. – prubin Mar 04 '22 at 19:50
  • I think my model may be a bit more robust with regard to no-good cuts. Your solutions $P$ and $Q$ would match on some variables but differ on the $y$ variables, so a no-good cut that included $y$ would not remove both. – prubin Mar 04 '22 at 19:53
  • Yes I think you are right. I have fixed the no good cut strategy to prevent this from happening, and added results for $M=2,...,10$. It looks stable. – Kuifje Mar 05 '22 at 01:48
3

Here's an approach that uses the network solver in SAS (disclaimer: I work at SAS) to enumerate all elementary paths in the line graph up to a maximum length:

data indata;
   input i j @@;
   from = compress(i||'');
   to   = compress(j||'');
   datalines;
1 2  1 4  1 8
2 6  2 8
3 3  3 8  3 9
4 3  4 4  4 6  4 7
5 9
6 5  6 10
7 1  7 5
8 3  8 10
9 1  9 7  9 10
;

proc optmodel; /* read original data */ set <str,str> LINKS_ORIG; read data indata into LINKS_ORIG=[from to]; LINKS_ORIG = LINKS_ORIG union {<'source','1'>,<'10','sink'>};

/* construct line graph */ set SOURCE = {'source_1'}; set SINK = {'10_sink'}; set LINKS = setof {<i,j> in LINKS_ORIG, <(j),k> in LINKS_ORIG diff {<i,j>}} <i||''||j, j||''||k>;

/* call network solver / set <str,str,num,num,str,str> PATHSLINKS; / <source,sink,id,order,from,to> */ solve with network / path=(source=SOURCE sink=SINK maxlength=11) direction=directed links=(include=LINKS) out=(pathslinks=PATHSLINKS);

/* count path lengths */ set PATHS = 1..OROPTMODEL_NUM['NUM_PATHS']; num length {PATHS} init -1; for {<s,t,p,o,from,to> in PATHSLINKS} length[p] = length[p] + 1; num len; set LENGTHS init {}; num lengthCount {LENGTHS} init 0; for {p in PATHS} do; len = length[p]; LENGTHS = LENGTHS union {len}; lengthCount[len] = lengthCount[len] + 1;
end; num cumulativeLengthCount {l in LENGTHS} = lengthCount[l] + (if l-1 in LENGTHS then cumulativeLengthCount[l-1]); print lengthCount cumulativeLengthCount; quit;

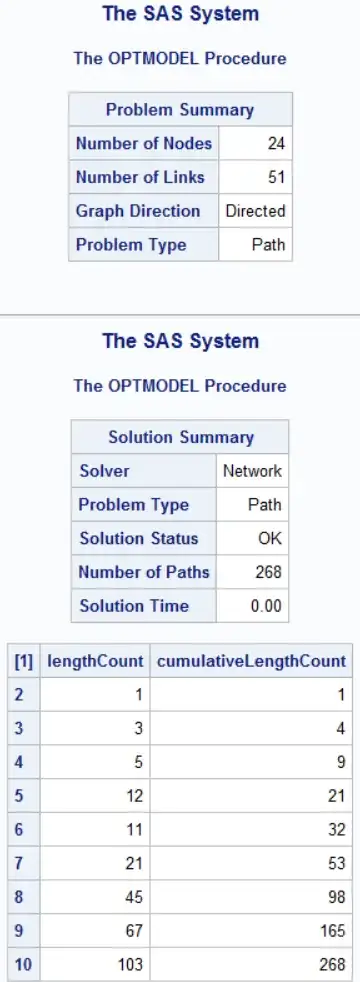

enter image description here

You can also find the $9$ shortest paths as in @Kuifje's answer by changing the SOLVE statement as follows:

   solve with network / shortpath=(source=SOURCE sink=SINK maxPathsPerPair=9) direction=directed links=(include=LINKS) out=(pathslinks=PATHSLINKS);
RobPratt
  • 32,006
  • 1
  • 44
  • 84
  • Is it possible to explain how the network solver achieves this behind the curtains ? Or is it considered confidential ? – Kuifje Mar 06 '22 at 18:48
  • SAS's path enumeration algorithm is roughly based on: https://ieeexplore.ieee.org/document/1602189

    It is pretty much brute force - which in this case (if implemented carefully) as Paul mentions above - is going to be much faster than anything elegant.

    – Matthew Galati Mar 06 '22 at 20:01
  • SAS's K-shortest path algorithm (maxPathsPerPair= option) uses Yen's algorithm. – Matthew Galati Mar 06 '22 at 20:10
1

I am trying to use the critical path method with a bit of modification to find all of the paths on the directed graph. Also, this is my first attempt and I am pretty sure that it can be better with some of the trials and errors. Indeed, I should work on the capture of the second limitation (a given path does not contain more than M arcs). What I do comes in the following comments of the original question.

The CPM is the fundamental algorithm to find the completion time of the project schedule problems on many of the commercial software. I am using a simple example to make a comparison on what @Kuifje purposed.

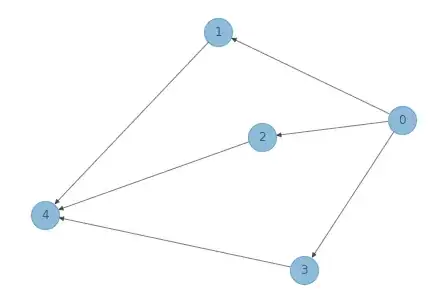

In the following network there are three paths: enter image description here

By calculation of the either forward and backward passes in the CPM, the following results are figured out:

task id, task name, active
10,       A,          True
20,       B,          True
25,       C,          True
30,       D,          True
40,       E,          True

In the above table, the numbers $10, 20, 25, 30, 40$ are corresponding to the nodes $0, 1, 2, 3, 4$ respectively and it means that all of the three paths are active. The achieved result by @Kuifje formulation is also equal to three.

A.Omidi
  • 8,832
  • 2
  • 13
  • 49
  • unfortunately, I cannot find any reference to illustrate the complexity of the CPM and I would appreciate if anyone mentions that. :) – A.Omidi Mar 07 '22 at 07:42
